Energiekontor Stock: An Overhead Line Costs 85 Percent of Guidance — and the 2028 Target Is Missing From the Report

Energiekontor Stock: An Overhead Line Costs 85 Percent of Guidance — and the 2028 Target Is Missing From the Report

On August 13, 2026, Energiekontor confirmed €40 million to €60 million of earnings before taxes in its half-year report — and cut guidance to €5 million to €10 million the same day. The nine-month statement of November 12 sticks with that range. We read what it says about Scotland — and that the €120 million target for 2028 no longer appears in it.

Thomas Mücke Founder & Publisher
· · 18 min read
Energiekontor Stock: An Overhead Line Costs 85 Percent of Guidance — and the 2028 Target Is Missing From the Report
Own illustration: TickerGuard · Source: half-year financial report 2026, ad hoc announcement of August 13, 2026 and Q3/9M 2026 quarterly statement (Energiekontor AG)

Chart

Interactive price chart (TradingView).

Note: pure fact-based analysis, not investment advice and not a solicitation to buy or sell. All figures without guarantee.

There is an investor trap that makes nobody rich and plenty of people nervous: the calendar-slice trap. We cut a company's life into twelve-month slices, put two of them side by side and treat the comparison as a verdict. With Energiekontor (Xetra: EKT) we warned against exactly that in August 2026: a weak half-year is no verdict on a project developer, the money comes in the second half. A few hours after our update of August 13, 2026, that sentence was out of date. Energiekontor cut its full-year guidance for earnings before taxes from €40 million to €60 million down to €5 million to €10 million. The trap has a second side, and that is what this piece is about: if you dismiss every weak slice as an exception, at some point you miss the pattern. We read the nine-month quarterly statement of November 12, 2026. What you make of it is your call.

What Energiekontor does: developer and owner at the same time

Energiekontor is based in Bremen, was founded in Bremerhaven in 1990 and has been listed since May 25, 2000. The company plans, builds and sells wind and solar parks in Germany, the United Kingdom, France, Portugal and the United States — and keeps a growing share of them on its own books.

That creates two very different sources of money. The first is the project business: develop a park, get it permitted, build it and sell it. It is lucrative, but it pays out in lumps — a single sale can swing a whole year. The second is the own portfolio: parks Energiekontor keeps and whose power it sells. That is the quiet part, a kind of rental income paid in megawatt hours.

At September 30, 2026 that own portfolio comprised 41 wind and solar parks with around 461 megawatts — 34 parks in Germany (around 363 MW), three in the United Kingdom (around 60 MW) and four in Portugal (around 38 MW). Eight more projects with around 227 megawatts are under construction for the own portfolio; with them it is set to grow to more than 680 megawatts. Next in line, according to the quarterly statement, are two solar parks in Mecklenburg-Western Pomerania with around 113 megawatts combined, scheduled for the fourth quarter of 2026. The group's internal yardstick is earnings before taxes (EBT) — the figure Energiekontor also uses for its guidance.

Company history for investors

  1. 2000

    Stock market listing

    First listed on May 25, 2000; the two founders still held more than half of the shares between them at September 30, 2026.

  2. 2022

    2023 to 2028 growth strategy

    Target of around €120 million of EBT in 2028 — the yardstick investors were invited to use for years.

  3. 2023

    Earnings before taxes of €95.5 million

    In the strategy base year, earnings came in far above the planned target range of €55 million to €60 million — a sign of what a year with many project sales can deliver.

  4. 2025

    Guidance cut in October

    From €70–90 million to around €30–40 million of EBT; €40.5 million was achieved. Sales slipped into 2026.

  5. 2026

    Guidance slashed on August 13

    From €40–60 million to €5–10 million of EBT due to delayed grid connections in Scotland; the stock lost almost a quarter in two trading days.

How the stock landed on our desk

Energiekontor showed up in July 2026 among the most-discussed names on the German investor forum wallstreet-online — next to far more speculative tickers. That is an attention signal, not a reason to buy. What caught our eye was the contrast: no crash story, no gambling stock, but a company that reported pre-tax profits of roughly €36 million to €96 million in each year from 2023 to 2025. That is why we looked. Since then we have updated the analysis with every report, most recently in November 2026 with the quarterly statement for the first nine months, published November 12, 2026.

The numbers over the years, given their due

First, what genuinely impresses: Energiekontor made money in each of the last three fiscal years — only the first half of 2026 ended in a loss. In 2025 sales came to €167.9 million (2024: €126.5 million), EBITDA to €86.1 million and earnings before taxes to €40.5 million (2024: €36.2 million). Net profit was €41.0 million, or €2.94 per share.

Now put 2023 next to it: €241.8 million of sales, €95.5 million of EBT, €5.97 per share. Between 2023 and 2024 earnings before taxes fell by almost two thirds — not because the business collapsed, but because large project sales slipped into a different calendar year.

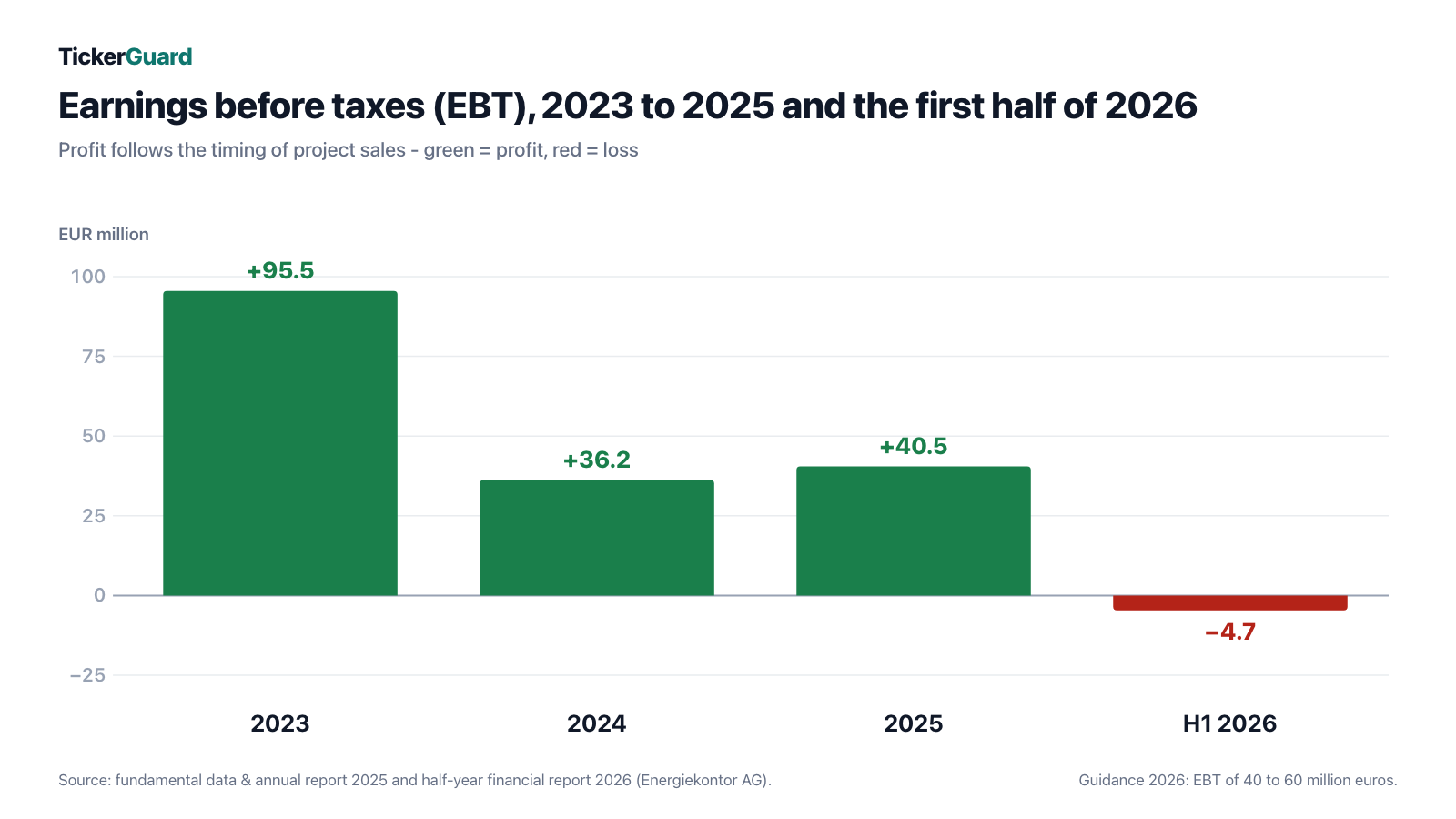

Bar chart of Energiekontor's earnings before taxes: €95.5 million in 2023, €36.2 million in 2024, €40.5 million in 2025 and minus €4.7 million in the first half of 2026.
Earnings before taxes jump with the timing of project sales — almost €96 million in 2023, a loss in the first half of 2026. For full-year 2026, Energiekontor has expected only €5 million to €10 million since August 13, 2026. Source: fundamental data & annual report 2025 and half-year financial report 2026 (Energiekontor AG). Click the image to open the full resolution.

There is a second picture that no calendar slice shows: guidance has been cut sharply in the second half two years running. In 2025 Energiekontor started with €70 million to €90 million of EBT and lowered the range to around €30 million to €40 million in October 2025; the year ended at €40.5 million. In 2026 guidance started at €40 million to €60 million and has stood at €5 million to €10 million since August 13, 2026. Both times the mechanism was the same: expected project sales slid into the following year. Energiekontor makes no secret of this volatility. The letter to shareholders of August 2026 puts it in one sentence:

"Experience has shown that significant earnings contributions are predominantly realised in the second half of the year, and in some cases not until towards the end of a financial year."

— Energiekontor AG, half-year financial report 2026, letter to the shareholders, page 8

The first half of 2026: more sales, less profit

On August 13, 2026 Energiekontor reported its figures for January 1 to June 30, 2026. Sales rose 31 percent to €99.9 million (prior-year period: €76.0 million) and total output to €182.8 million (€171.5 million). From there the line points down: EBITDA €21.1 million (€51.0 million), EBIT €10.1 million (€39.3 million) — and earnings before taxes of minus €4.7 million after plus €28.3 million. The group loss was €5.3 million, the loss per share €0.38.

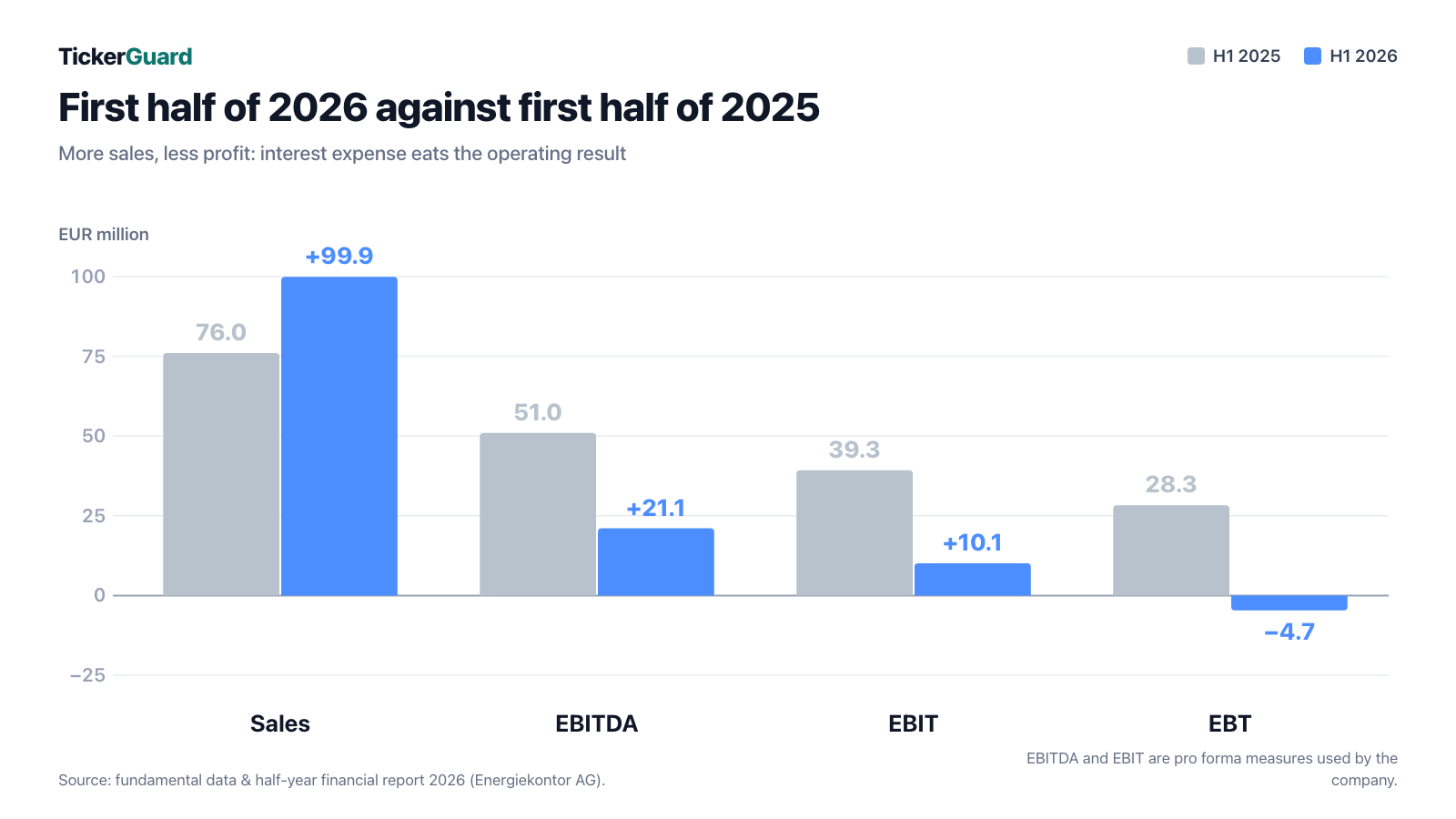

Bar chart comparing Energiekontor's first halves of 2025 and 2026: sales €76.0 million versus €99.9 million, EBITDA €51.0 million versus €21.1 million, EBIT €39.3 million versus €10.1 million and earnings before taxes €28.3 million versus minus €4.7 million.
Four metrics, two half-years: only sales point upward. Source: fundamental data & half-year financial report 2026 (Energiekontor AG). Click the image to open the full resolution.

The segments show where the hole was. In the first half of 2026 segment EBT in project development came to minus €12.9 million (prior-year period: plus €22.9 million). Power generation from the own parks, by contrast, delivered plus €7.0 million (€4.8 million) and operations management plus €1.3 million (€0.6 million). The quiet part of the business did its job — the lumpy part did not.

August 13, 2026: one day, two forecasts

The half-year financial report of August 13, 2026 still carried the full-year guidance: €40 million to €60 million of group EBT, contingent on ready-to-build project sales in the United Kingdom, for which the grid connection offers from the system operator NESO were still missing, and on the handover of three German wind parks that had already been sold.

Highlighted excerpt from Energiekontor's half-year financial report 2026: marked in yellow with a red border, the note on the outstanding NESO grid connection offers due by mid-September 2026 at the latest and the sentence that the earnings forecast of €40 million to €60 million remains achievable.
The passage in the original: in the half-year financial report of August 13, 2026, the open grid connection question and the confirmed €40 million to €60 million guidance sat directly beneath each other — the same day, guidance was cut to €5 million to €10 million by ad hoc announcement. Highlighting ours. Source: energiekontor.de. Click the image to open the full resolution.

The ad hoc announcement followed the same day — a mandatory disclosure under Article 17 of the EU Market Abuse Regulation, which a listed company must publish immediately when it has price-sensitive news. The new range: €5 million to €10 million. Measured from the midpoint of the old range (€50 million) to the midpoint of the new one (€7.5 million), that is 85 percent less. The announcement itself explains the hurry:

"Contrary to the earnings guidance confirmed in the 2026 half-year financial report, new developments regarding the grid connection dates of several Scottish wind park projects have emerged following its publication."

— Energiekontor AG, ad hoc announcement of August 13, 2026

The core of it: the planned grid connections of three Scottish wind park projects move from 2029 to 2031 because the consent for an overhead line of the grid operator Scottish Power Transmission is being challenged in court. Projects with around 1.4 gigawatts in total are meant to connect to that line. According to the ad hoc announcement, two of the three delayed projects were a key part of the full-year guidance and were in the sales process.

The market reacted sharply. On August 12, 2026 the stock closed at €34.50 on XETRA, on August 14 at €26.05 — almost a quarter lower in two trading days (closing prices from fundamental data). The quarterly statement reports the lowest close of the first nine months on September 2, 2026, at €23.80.

The nine-month statement of November 12, 2026: what is in it, and what is missing

First, so nobody looks for something that is not there: the quarterly statement for the first nine months contains no income statement, no balance sheet and no cash flow statement. Energiekontor does not report sales, EBT, liquidity or debt as of September 30, 2026. The latest financials remain those at June 30, 2026. According to the financial calendar, Energiekontor scheduled no conference call or webcast for the statement; we had no transcript of an analyst call for this quarter. We evaluated the quarterly statement in its German and English versions and the press release of the same day.

The key line sits in the outlook: the range set on August 13 still stands.

"In an ad hoc announcement dated 13 August 2026, the Management Board adjusted the forecast to a range of five to ten million euros. Energiekontor continues to expect Group EBT within this range."

— Energiekontor AG, quarterly statement Q3/9M 2026, outlook chapter

The arithmetic: after minus €4.7 million in the first half, the second half has to contribute €9.7 million to €14.7 million before taxes. Part of that is already booked: in October 2026 the Elsdorf-Frankeshoven and Elsdorf-Tollhausen wind parks, sold to the town of Elsdorf, went into operation with around 40 megawatts combined and were handed over. That means all three German parks sold on a turnkey basis in 2025 — including Drensteinfurt-Rieth in June — have been completed with earnings recognised in fiscal 2026.

For the segments, the statement gives only directions: project development and sales "significantly below the prior-year level" (2025: €20.8 million), power generation and operations management each "approximately in line with the prior-year level" (2025: €17.1 million and €2.5 million). If you plug in the two quiet segments at last year's values, the project business works out at roughly minus €10 million to minus €15 million. That is our back-of-the-envelope estimate without consolidation effects; Energiekontor gives no figure for the segment.

Construction carried on. In the first nine months four wind parks with around 88 megawatts were commissioned, around 24 megawatts of them for the own portfolio. At September 30, 2026, 20 projects with around 609 megawatts were under construction or financed. Building permits grew to 36 projects with around 1,305 megawatts by November 12, 2026. The own parks generated around 480 gigawatt hours of power in nine months after around 413 a year earlier — more parks and better wind than in the very calm prior year, but still below plan: wind in Germany reached 87.5 percent of the long-term average, solar irradiation 79.5 percent of plan.

And then something is missing. The Q1 2026 quarterly statement had a dedicated section on the "2023 to 2028 growth strategy", and so did the half-year report. In the nine-month statement it no longer appears — more on that in the chapter on the 2028 plan.

Uncomfortable truth no. 1: a buyer, an overhead line, a court case

What tipped the balance is only spelled out in the nine-month statement. It was not just the delay — it was a buyer who pulled back:

"The forecast adjustment was prompted by an investor's notification that it no longer intended to complete the relevant transactions in the United Kingdom through the acquisition of the project companies in the 2026 financial year as previously planned."

— Energiekontor AG, quarterly statement Q3/9M 2026, outlook chapter, section "Further developments in the United Kingdom"

That is the weak point of the British model in everyday terms: Energiekontor sells projects there ready to build, before construction starts — like a developer selling a permitted plot together with the plans. What such a project is worth depends on the grid connection: when the power may flow and what the connection costs. If that shifts, the sale shifts. And here the timetable is set not by Energiekontor, but by a court:

"Energiekontor is neither a defendant nor otherwise involved in the proceedings and receives no official information on their status, substance or prospects of success."

— Energiekontor AG, quarterly statement Q3/9M 2026, outlook chapter

In September 2026 the new grid connection offers arrived for seven Scottish projects with more than 350 megawatts; they provide for connections between 2029 and 2032. Four of the seven are affected by the court case. Most offers carry a three-month acceptance period, during which Energiekontor intends to resolve open questions and, where appropriate, challenge the assigned connection costs. The grid operator expects the case to conclude in the first half of 2027. For seven more projects with more than 480 megawatts, Energiekontor expects offers by the end of the first quarter of 2027, generally for connections between 2031 and 2035.

The weight of this question is considerable. At September 30, 2026, around two thirds of all existing building permits, measured by capacity, related to the British project business. CEO Peter Szabo put it this way in the press release of November 12, 2026: "In the United Kingdom, we are looking beyond the current delays and are focusing on the further development of our project pipeline." There is no date for the postponed sales in it. The ad hoc announcement considered it more likely that the earnings contributions would move to the next financial year — that is not a commitment for 2027.

Uncomfortable truth no. 2: interest eats the operating profit

The gap between EBIT and EBT at Energiekontor is not a rounding error; it is an interest bill. In the first half of 2026 operating profit of €10.1 million faced interest expense of €16.1 million (prior-year period: €12.8 million). The financial result came to minus €14.7 million after minus €11.0 million. There are no newer figures — the nine-month statement contains no income statement.

What does that mean in plain terms? Interest coverage — how many times operating profit can pay the interest — was roughly 0.6 in the half-year. The operating business generated only about 62 cents for every euro of interest. For the full year a simple equation applies: earnings before taxes equal operating profit plus the financial result. If the new guidance is met, operating profit in 2026 will exceed the negative financial result — but with a cushion of only €5 million to €10 million.

The cause sits on the balance sheet. At June 30, 2026, long-term financial liabilities stood at €409.1 million (December 31, 2025: €378.6 million) and short-term ones at €390.1 million (€365.1 million). Much of that is project finance tied to individual parks — but the interest is real all the same, and it keeps running when a sale arrives a year late.

Uncomfortable truth no. 3: the pipeline is shrinking — by choice

For years the growing project pipeline was the showpiece. At June 30, 2026 it got smaller: 11,287 megawatts excluding US project rights (December 31, 2025: 11,574), and together with 602 megawatts of US solar rights around 11.9 gigawatts after around 12.2 gigawatts at the end of 2025. That is 287 megawatts or 2.5 percent less. The nine-month statement gives no newer pipeline figure.

The half-year report addressed this head-on:

"The slight decline is primarily attributable to the decision not to pursue certain projects in the early stages of development as part of the ongoing prioritisation of the project pipeline."

— Energiekontor AG, half-year financial report 2026, chapter "Our valuable project pipeline", page 16

As reasons, the report cited the marked decline in award prices in German tenders and the still-open effect of Germany's 2027 renewable energy law reform (EEG) and grid connection package. Neither law had been passed by November 12, 2026; the Bundestag held its first reading of both on September 24, 2026. Award values for onshore wind fell round by round in 2026: 5.54 cents per kilowatt hour in February, 5.06 in May, 4.79 in August. You can read the pipeline cut as discipline — fewer projects, but ones that pencil out. It is not a good sign for market prices.

Uncomfortable truth no. 4: the equity cushion is thinning

The balance sheet at June 30, 2026 — the latest one available — has grown, but at different speeds on each side. Total assets rose to €1,127.5 million (December 31, 2025: €1,077.9 million), while equity fell to €201.3 million (€224.7 million). That pushed the equity ratio down from 20.8 to 17.9 percent.

Two things belong in a fair reading. First, Energiekontor paid its dividend after the annual general meeting at the end of May 2026 — money that leaves by design. Second, the group also reports a notional equity ratio that treats non-recourse project finance differently; it stood at 25.2 percent after 29.0 percent. Both figures point the same way.

Liquidity also declined: cash and securities combined came to €178.0 million after €194.6 million at year-end. Operating cash flow was minus €26.0 million after plus €18.6 million a year earlier. On top of that came inventories — capitalised costs for projects under construction and in marketing — of €472.4 million, more than twice equity. How these items developed through September 30 the nine-month statement does not say; the next look at the balance sheet comes with the 2026 annual report.

The plan to 2028 — and its gap in the latest report

The growth target has been in place since fiscal 2022: group EBT is to rise to around €120 million by 2028, starting from the 2023 base year — around 15 percent a year on average. The base is not the actual 2023 result of €95.5 million but the target range of €55 million to €60 million set for 2023 at the time. That is how the Q1 2026 quarterly statement put it:

"The company aims to increase its Group EBT by an average of 15 percent per year in the period from 2023 to 2028."

— Energiekontor AG, quarterly statement Q1 2026

Highlighted excerpt from Energiekontor's Q1 2026 quarterly statement: the passage marked in yellow with a red border stating that the company aims to grow group EBT by an average of 15 percent per year from 2023 to 2028.
The passage in the original: the 2023–2028 growth target in the Q1 2026 quarterly statement. The Q3/9M 2026 statement no longer has this section. Highlighting ours. Source: energiekontor.de. Click the image to open the full resolution.

The half-year financial report of August 13, 2026 still carried the target — with a caveat that, in substance, had already appeared in the Q1 2026 quarterly statement:

"The regulatory and market conditions have changed and become more complex since the strategy was adopted."

— Energiekontor AG, half-year financial report 2026, chapter "Outlook", page 42

In the Q3/9M 2026 quarterly statement of November 12, 2026, the "2023 to 2028 growth strategy" section is missing — in the German and the English version alike. The Q3/9M 2025 statement still had it, even after that year's guidance cut, so its absence is not down to the format of the nine-month statement. Neither the €120 million nor the 15 percent is mentioned. That is not a withdrawal of the target; the company simply says nothing about it. Read against the numbers, the gap would be large: from 2026 guidance of €5 million to €10 million, earnings before taxes would have to grow twelve- to twenty-four-fold by 2028. If you took the roadmap seriously, check the 2026 annual report to see whether it still holds.

Dividend and buyback

For 2025 the annual general meeting on May 27, 2026 approved a dividend of €1.00 per share, after €0.50 for 2024. That paid out around 35 percent of the distributable profit of Energiekontor AG (2024: around 43 percent).

Highlighted excerpt from Energiekontor's annual report 2025: the red-bordered passage stating that the proposed distribution corresponds to a dividend of €1.00 per share, after €0.50 in the prior year, at around 35 percent of distributable profit.
The passage in the original: the €1.00 per share dividend proposal in the annual report 2025, explicitly described as around 35 percent of distributable profit (2024: around 43 percent). Highlighting ours. Source: energiekontor.de. Click the image to open the full resolution.

So far the payout has followed earnings: more in good years, less in weak ones. There is no proposal for fiscal 2026 yet. With expected group EBT of €5 million to €10 million, it would not be consistent to count on the same payout as for 2025.

The buyback is worth a close look at the dates. Under the programme started in July 2025, a total of 47,314 shares were bought by April 2, 2026 and then cancelled; that cut the share count to 13,894,772 shares (as of November 12, 2026). The new programme of May 28, 2026 allows up to 80,000 shares for no more than €9.0 million until May 27, 2027 at the latest. By September 30, 2026, Energiekontor had bought just 1,100 shares at an average of €45.03 under it. The weekly buyback list on energiekontor.de shows when: all 1,100 shares in the week of June 1 to 5, 2026. Since then — including after the slump — the list shows not a single further repurchase (retrieved November 13, 2026). There were no reportable share dealings by management or supervisory board members in the first nine months. There is still no authorised capital, so no dilution through new shares is currently in place.

What the stock really is

At September 30, 2026 the stock closed at €24.90 (XETRA) — 30.3 percent below the 2025 year-end close of €35.75, while the SDAX gained 5.5 percent over the same period. The nine-month high was €49.80 on May 20, 2026. The company puts its market capitalisation at September 30 at around €346 million. On November 11, 2026, the day before the nine-month statement, the stock closed at €23.00; with 13,894,772 shares that is a market value of around €320 million.

What does that mean in multiples? Against 2025 earnings per share of €2.94, the price-to-earnings ratio would be just under 8 — seemingly cheap. Against 2026 guidance, by contrast, the company costs 32 to 64 times its expected earnings before taxes. Both numbers are calendar slices, and both mislead: the first assumes a profit that will not recur in 2026, the second a year without the British sales. The 2025 dividend equals around 4.3 percent of the November 11, 2026 close — a look back, not a promise.

Unlike Verbio, the value here does not hinge on a state-set price, and unlike thyssenkrupp it is not about breaking up a conglomerate, but about construction projects with long lead times. It is the question of what the British projects, the growing own portfolio and the German permits are worth if the sales arrive one or more years later than planned.

One more point on the shareholder structure: according to the quarterly statement, the two founders Dr. Bodo Wilkens and Günter Lammers still held more than 50 percent of the share capital between them at September 30, 2026; as of November 12, 2026 it shows around 25.6 percent each. That brings stability and staying power — and means the other shareholders cannot form a majority as long as both founders vote the same way.

Upside and risks at a glance

Upside:

  • The own portfolio is growing: 41 parks with around 461 megawatts at September 30, 2026, another 227 megawatts or so under construction — including two solar parks with around 113 megawatts scheduled for the fourth quarter of 2026. In the first half of 2026 this part delivered €7.0 million of segment EBT.
  • Building permits rose to 36 projects with around 1,305 megawatts by November 12, 2026; in Germany, permits for nine wind park projects with around 250 megawatts were added in 2026 through October 9, 2026.
  • All three German wind parks sold in 2025 were handed over on schedule in 2026 with earnings recognised.
  • The first new British grid connection offers are in (seven projects, more than 350 megawatts, connections 2029 to 2032); more for over 480 megawatts are announced by the end of the first quarter of 2027.
  • No authorised capital; cash and securities of €178.0 million at June 30, 2026.

Risks:

  • 2026 guidance was cut on August 13, 2026 from €40–60 million to €5–10 million of EBT — the second sharp second-half cut in a row after October 2025.
  • Four of seven Scottish projects depend on a court case Energiekontor is not party to; an investor has postponed the planned takeover.
  • Interest coverage of around 0.6 in the first half: €16.1 million of interest expense against €10.1 million of EBIT; financial liabilities of around €799 million at June 30, 2026.
  • Equity ratio down from 20.8 to 17.9 percent, inventories at €472.4 million; the nine-month statement contains no newer balance sheet.
  • The target of around €120 million of EBT for 2028 is no longer mentioned in the nine-month statement; German onshore wind award prices fell in 2026 from 5.54 to 4.79 cents per kilowatt hour.

A human conclusion

Back to the calendar-slice trap. In August we used it in Energiekontor's defence: a half-year loss is no verdict on a project developer. That was true — and it still did not stop guidance from falling a few hours later. The trap snaps both ways. If you take a single weak slice for the whole, you judge too harshly. If you dismiss every weak slice as an exception, you miss that the same thing has happened two years running: the sales come later than the guidance says.

None of this makes Energiekontor a bad company. The own parks are growing and producing power, the German sales were delivered, the founders are on board, no new shares are being issued. But the most valuable part of the story — the British projects — hangs on an overhead line, a court and grid operators whose timetable Energiekontor does not control. And the 2028 target that carried the narrative for years is no longer in the latest report. The next checkpoints are the grid connection offers due by the end of the first quarter of 2027 and the 2026 annual report.

What you do with that is your decision. And that is how it should be.

Sources

Source: fundamental data & reports of Energiekontor AG (annual report 2025, half-year financial report 2026, quarterly statements Q1 and Q3/9M 2026, ad hoc announcement of August 13, 2026). Energiekontor is not an SEC filer: there are no annual reports (10-K) and no quarterly reports (10-Q); all evidence comes from the company's own publications. This analysis is journalistic commentary, not investment advice and not a solicitation to buy or sell securities. Stocks can fall to zero. We disclose the publisher's own positions on a daily basis; if one exists, it appears as a note at the top of this analysis.

Our Bottom Line at a Glance

Reliability of guidance negative
On 13.08.2026 EBT guidance was cut from €40–60M to €5–10M on the very day it was confirmed; in October 2025 the 2025 range had already been lowered from €70–90M to around €30–40M. Both times expected project sales slipped into the following year.
Dependence on the UK negative
Around two thirds of permitted capacity (30.09.2026) is in the United Kingdom. Four of seven Scottish projects with new grid connection offers depend on a court case against an overhead line that Energiekontor is not party to; the grid operator expects a conclusion in the first half of 2027.
Recurring revenue positive
41 own parks with around 461 MW (30.09.2026) generated around 480 GWh in nine months after 413 GWh. Around 227 MW for the own portfolio are under construction. For the power generation segment Energiekontor expects 2026 EBT roughly in line with the prior year (2025: €17.1M).
Delivery in Germany positive
All three German wind parks sold turnkey in 2025 — Drensteinfurt-Rieth, Elsdorf-Frankeshoven and Elsdorf-Tollhausen — were commissioned and handed over on schedule in 2026. Building permits rose to around 1,305 MW by 12.11.2026.
Interest burden and balance sheet negative
Interest expense of €16.1M against €10.1M of EBIT in the first half of 2026 (interest coverage around 0.6), equity ratio 17.9% after 20.8%, inventories €472.4M (30.06.2026). The nine-month statement contains no newer balance sheet.
Capital side neutral
No authorised capital, 13,894,772 shares (12.11.2026), founders holding more than 50% together. Under the buyback programme of 28.05.2026 only 1,100 of up to 80,000 shares had been bought by 30.09.2026, at an average of €45.03.

Energiekontor is a project developer that was profitable throughout 2023 to 2025 and has a growing own portfolio — but for the second year running its full-year guidance had to be cut sharply in the second half. Since August 13, 2026 the company expects only €5 million to €10 million of earnings before taxes for 2026 instead of €40 million to €60 million, because British project sales depend on a court case over an overhead line. The nine-month statement of November 12, 2026 confirms the range, provides no new financials and no longer mentions the 2028 target. Not investment advice.

What Our Rating Means

Open questions

The business works in principle, but one material question is open. As long as it stays open, our findings do not carry a quality verdict.

Yellow does not mean a question of survival here. At June 30, 2026 Energiekontor had €178.0 million of cash and securities, positive equity of €201.3 million and no authorised capital; the own parks make money even without sales, and for 2026 the company still expects positive earnings before taxes of €5 million to €10 million — so operating profit is meant to exceed the negative financial result for the full year. Yellow stands because a material operating question is open and has sharpened since August: when the British projects get sold depends on a court case and on grid connection offers Energiekontor does not control, and guidance has been cut sharply in the second half two years running. On top come interest coverage of around 0.6 in the first half and an equity ratio down to 17.9 percent. The next checkpoints are the grid connection offers due by the end of the first quarter of 2027 and the 2026 annual report. The decision is yours.

A journalistic assessment by our editorial team at the time of the deep dive, based on public sources — not investment advice and not a solicitation to buy or sell. Your personal circumstances (investment goals, risk capacity, taxes) cannot be taken into account. What our levels mean, how verdicts are formed, and what conflicts of interest exist →

Worth Noting

  • Starting point: Energiekontor appeared among the most-discussed names on the German wallstreet-online forum in July 2026 — an attention signal, not a reason to buy. Updated on August 13, 2026 with the half-year financial report (before the ad hoc announcement of the same day was published) and on November 13, 2026 with the Q3/9M 2026 quarterly statement of November 12, 2026; this update incorporates the guidance cut of August 13, 2026.
  • Data cut-off November 12, 2026. The latest period report evaluated is the Q3/9M 2026 quarterly statement (January 1 to September 30, 2026), published November 12, 2026. It contains no income statement, balance sheet or cash flow statement; the financials therefore still come from the half-year financial report 2026 (reporting date June 30, 2026).
  • For the Q3/9M 2026 statement the financial calendar lists publication only — no conference call and no webcast. No transcript of an analyst call for this quarter was available.
  • Energiekontor is not an SEC filer: no annual reports (10-K), no quarterly reports (10-Q), no EDGAR identifier. All evidence comes from the company's reports on energiekontor.de; quotes are taken from the English versions.
  • Own calculations: interest coverage of around 0.6 = EBIT of €10.085M divided by interest expense of €16.144M (first half of 2026). Minus 85 percent = midpoint of the old range (€50M) versus midpoint of the new one (€7.5M). Required second-half EBT = €5M or €10M minus (−€4.7M). Project development and sales segment of around −€10M to −€15M = group range minus the prior-year values of the power generation (17.1) and operations management (2.5) segments, without consolidation effects.
  • Prices: closes on 30.09.2026 (€24.90), high on 20.05.2026 (€49.80) and low on 02.09.2026 (€23.80) from the Q3/9M 2026 statement; closes on 12.08.2026 (€34.50), 14.08.2026 (€26.05) and 11.11.2026 (€23.00) from fundamental data. Market value on 11.11.2026 = €23.00 × 13,894,772 shares.
  • EBITDA and EBIT are pro forma measures outside German GAAP and IFRS, according to the report. The notional equity ratio (25.2% at June 30, 2026) is a company metric that treats non-recourse project finance differently from the balance-sheet ratio of 17.9%.
  • Ticker note: EKT.DE simply means "Energiekontor, listed in Germany" and is not an official exchange code. The stock trades in the General Standard, not the Prime Standard.

The full analysis as a PDF for later

We will send you this analysis as a PDF — to print, file away, and read at your own pace.

We confirm your address by email first (double opt-in). You can unsubscribe with one click at any time.

Frequently Asked Questions

Because the grid connections of several Scottish wind park projects move from 2029 to 2031 due to a court case against an overhead line. An investor then said it would no longer take over the project companies in 2026 as planned. On August 13, 2026 EBT guidance therefore fell from €40 million to €60 million to €5 million to €10 million.

It confirms guidance of €5 million to €10 million of group EBT, reports the handover of the Elsdorf wind parks in October 2026 and new British grid connection offers for seven projects. It contains no income statement, balance sheet or cash flow, and it no longer includes the section on the 2028 growth target.

Energiekontor does not currently say. The Q1 2026 quarterly statement confirmed the target as achievable and the 2026 half-year report kept listing it. In the Q3/9M 2026 statement of November 12, 2026 it no longer appears. Confirmation or withdrawal can be expected in the 2026 annual report at the earliest.

A large part of the result comes from selling individual parks. The timing of those sales decides in which year the profit lands. Earnings before taxes were €95.5 million in 2023, €36.2 million in 2024 and €40.5 million in 2025; for 2026 Energiekontor expects €5 million to €10 million.

The latest balance sheet is from June 30, 2026: equity of €201.3 million, an equity ratio of 17.9 percent after 20.8 percent at the end of 2025, cash and securities of €178.0 million and operating cash flow of minus €26.0 million for the half-year. The statement for September 30 contains no balance sheet.

At September 30, 2026 Energiekontor operated 41 own wind and solar parks with around 461 megawatts. Another 227 megawatts or so are under construction for the own portfolio, which is set to grow to more than 680 megawatts. In the first nine months of 2026 the own parks generated around 480 gigawatt hours.

The annual general meeting on May 27, 2026 approved €1.00 per share for 2025, after €0.50 for 2024. That was around 35 percent of the parent company's distributable profit. There is no proposal for 2026 yet; guidance for earnings before taxes is €5 million to €10 million.

No. Energiekontor is a German stock corporation in the General Standard segment of the Frankfurt Stock Exchange and a member of the SDAX. There are no annual reports (10-K) and no quarterly reports (10-Q). All evidence comes from the company's own reports on energiekontor.de.
